Construction work of Sewage Pump Station Project Jeddah Airport Saudi Arabia

Construction work of Sewage Pump Station Project Jeddah Airport, Saudi Arabia

Project Partners:
Role Organization
Owner National Water Company (NWC)
Consultant Bayt Al Khibra for Engineering Consultants
Main Contractor Thrustboring Construction Co. Ltd. / Tamimi Group
Subcontractor EPF General Contracting Co.
Project Location Airport Area, Jeddah City, Kingdom of Saudi Arabia

Construction of a Sewage Pump Station near the Airport Area in Jeddah under NWC’s infrastructure development program.

The Pump Station project enhances wastewater management for the airport zone. EPF delivers all work in coordination with TCC, Bayt Al Khibra, and NWC.

Quality & Safety Compliance:

• Workers equipped with PPE.
• Rebar and formwork executed under HSE supervision.
• Materials inspected regularly per consultant specifications.

Current Work Progress

Project Update – May 2026

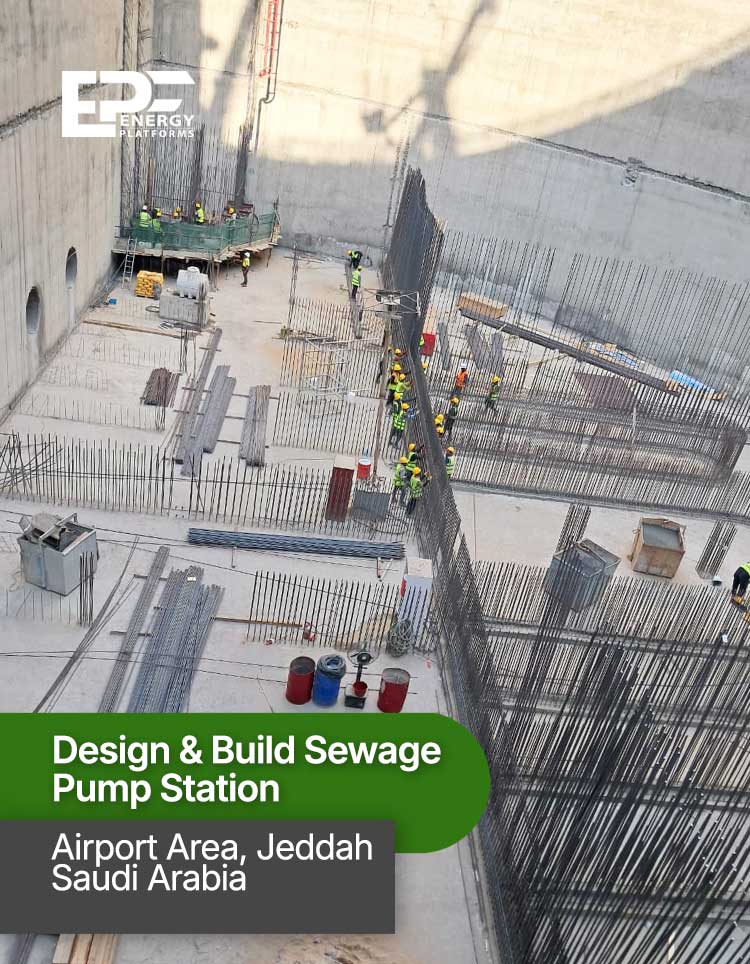

Phase 9

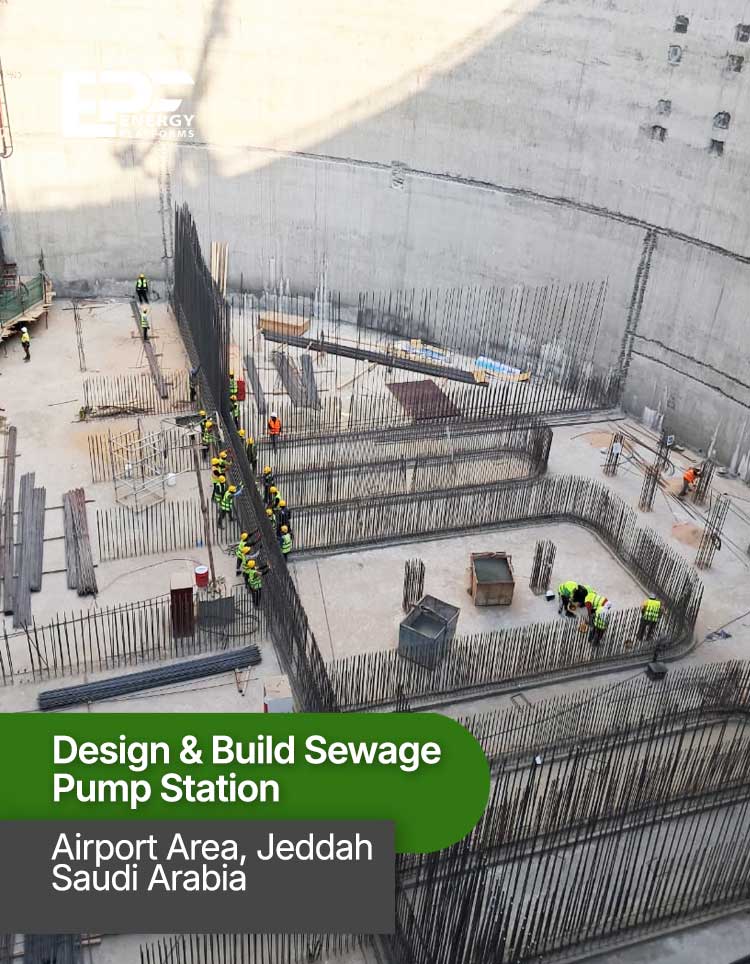

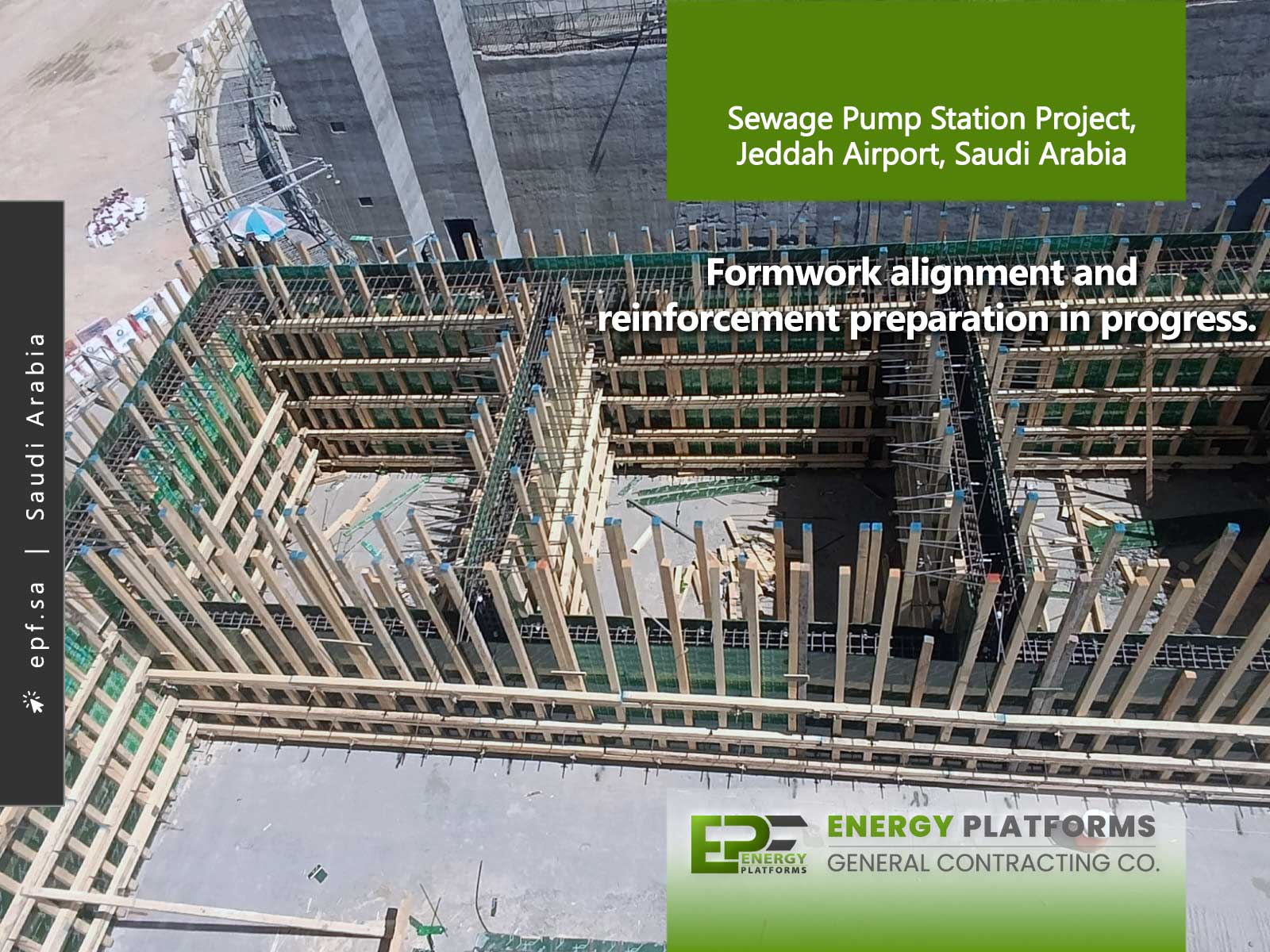

Upper Slab Structural Reinforcement

Upper slab reinforcement works, embedded openings, formwork checks, and site inspection were carried out as part of the next structural stage. The works were completed with proper coordination between site execution, engineering, quality, and safety teams.

Project Update – April 2026

Phase 8

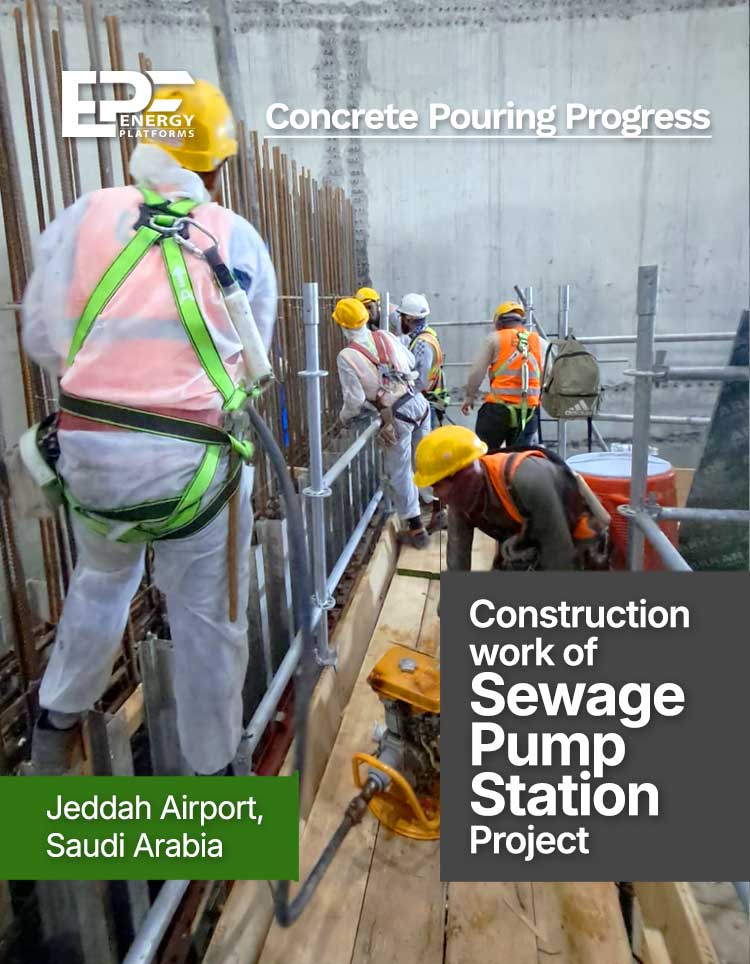

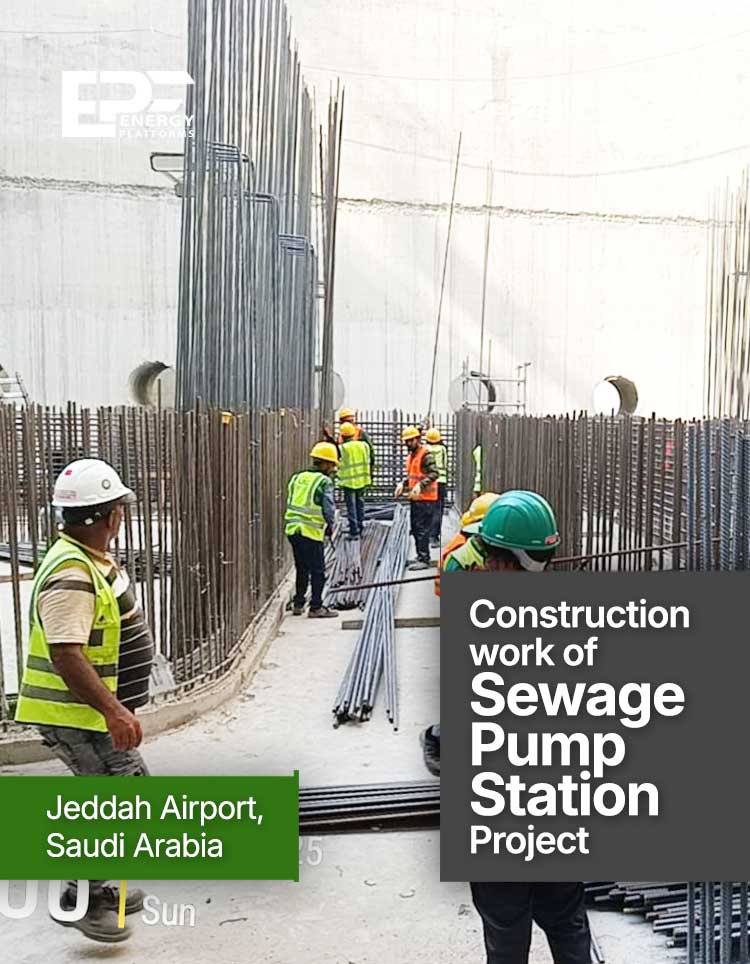

Wall Formwork & Structural Preparation

Vertical wall formwork, scaffolding, and support systems are being installed for the sewage pump station structure. Surveying, alignment verification, and material handling activities are ongoing in preparation for upcoming concrete works.

Project Update – January 2026

Phase 7

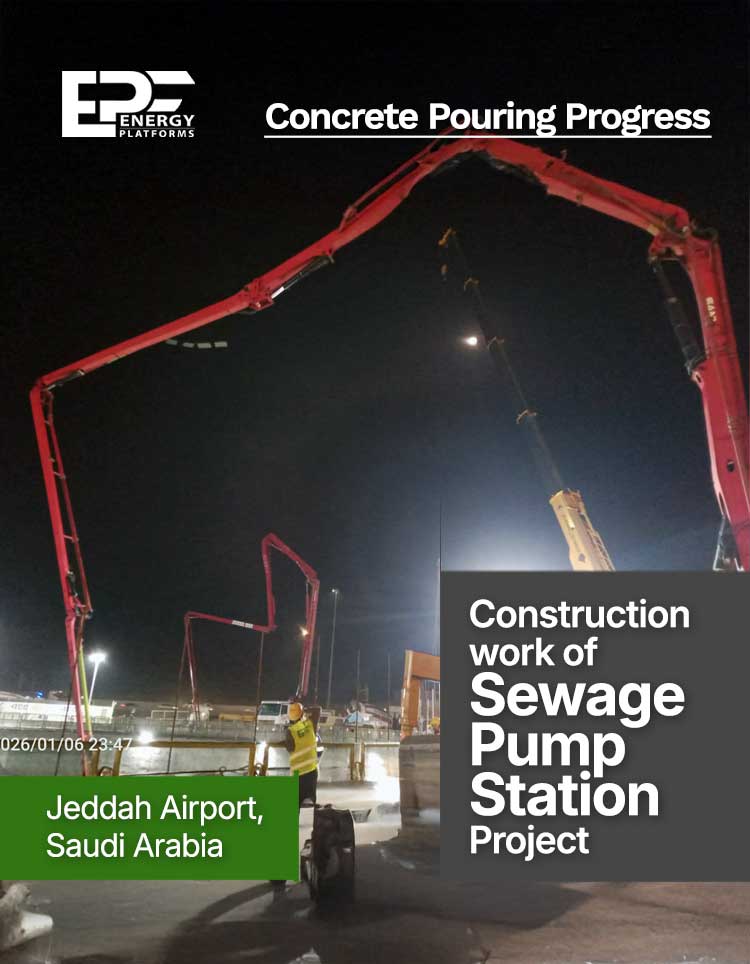

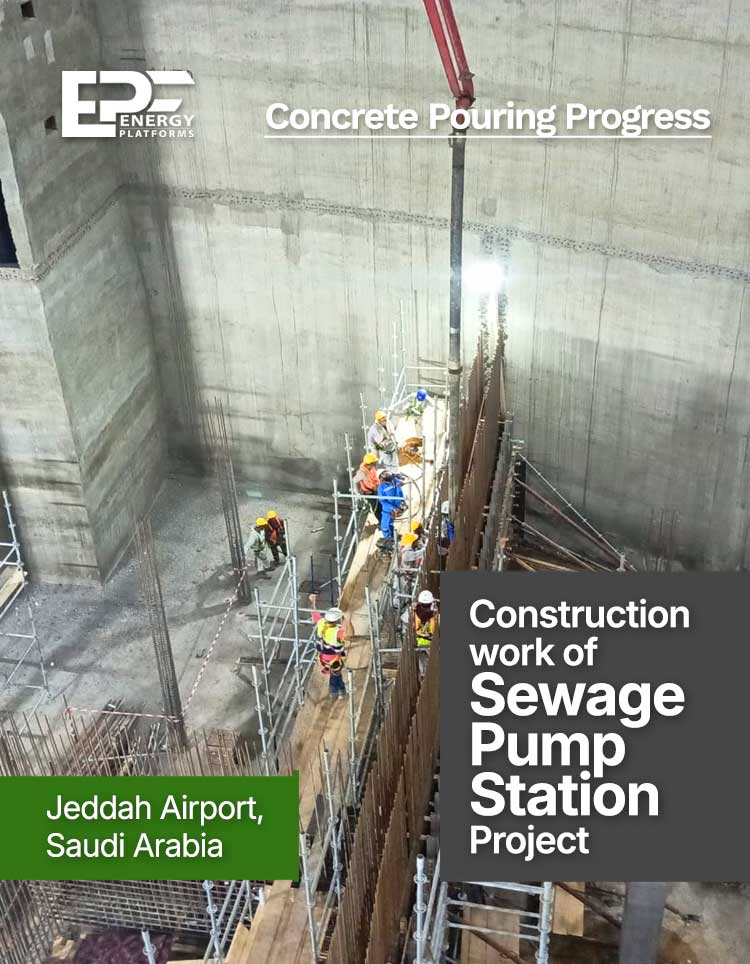

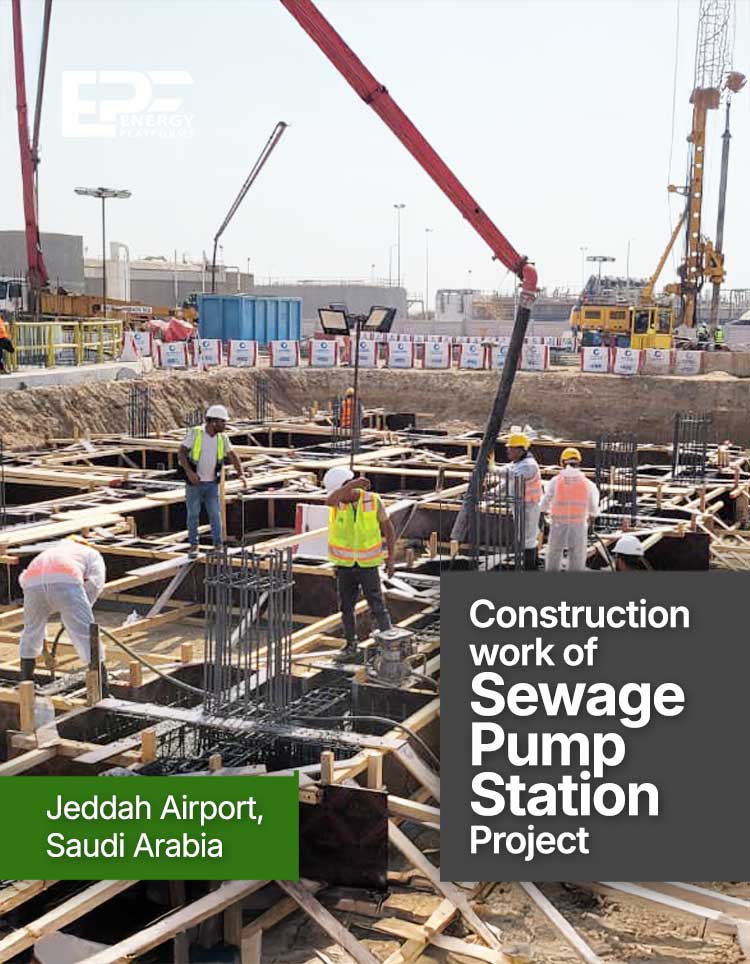

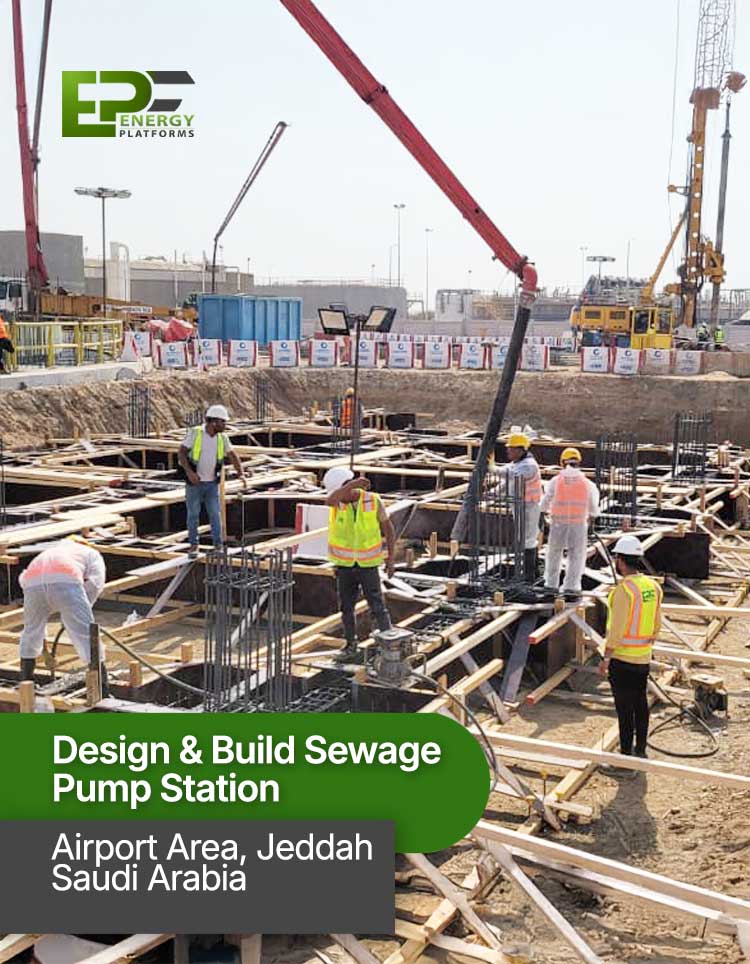

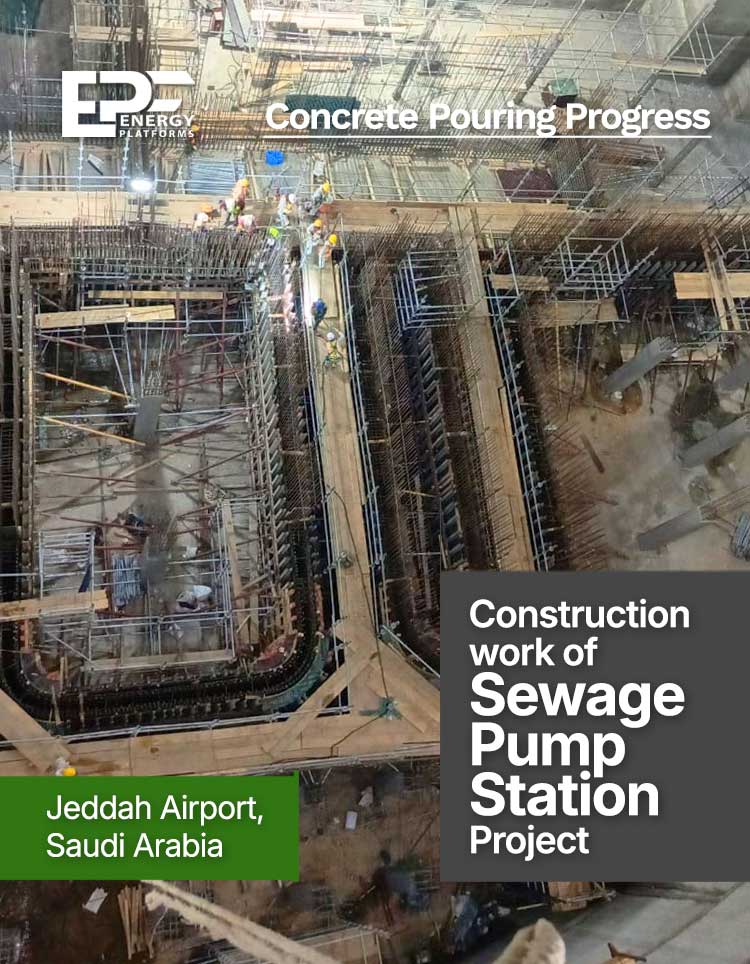

Concrete Pouring Progress

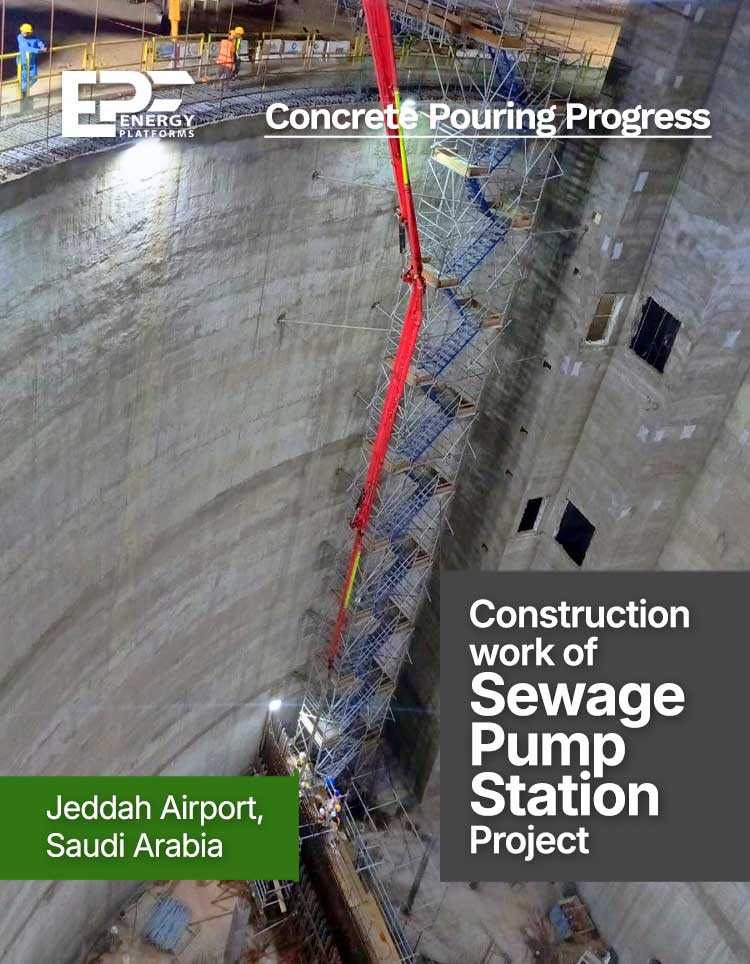

Ongoing concrete pouring works are being executed for the main shaft of the sewage pump station at Jeddah Airport, ensuring structural integrity, safety compliance, and timely project delivery.

Project Update – November 2025

Phase 6

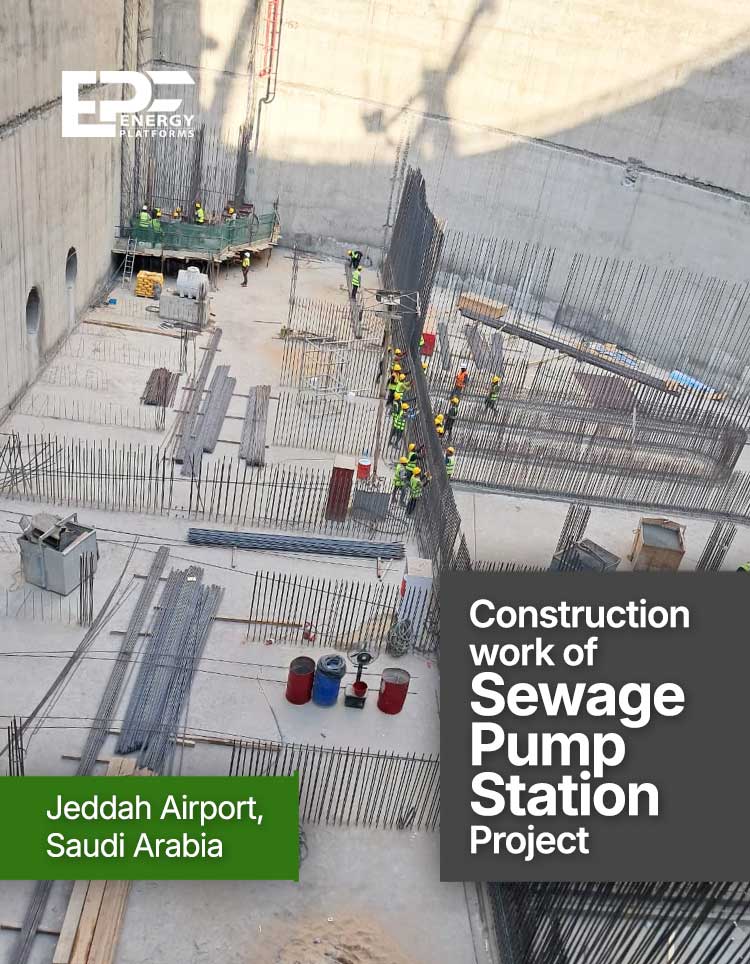

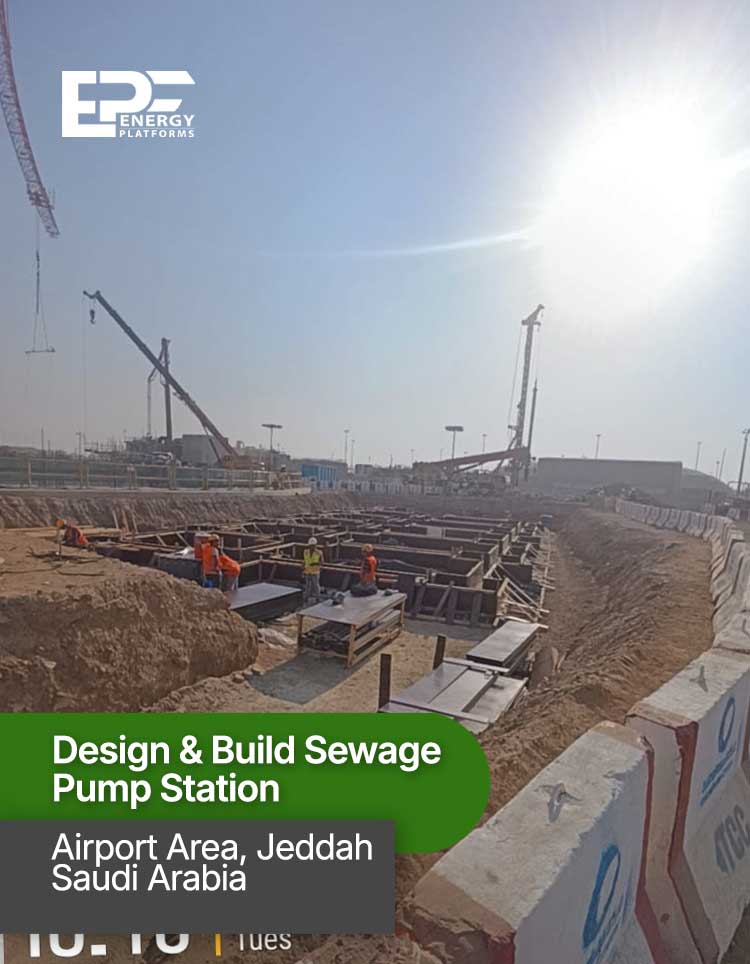

Wall Reinforcement & Formwork

Vertical reinforcement and chamber wall formwork progressing. Segments aligned and prepared for upcoming concrete activities.

Phase 5

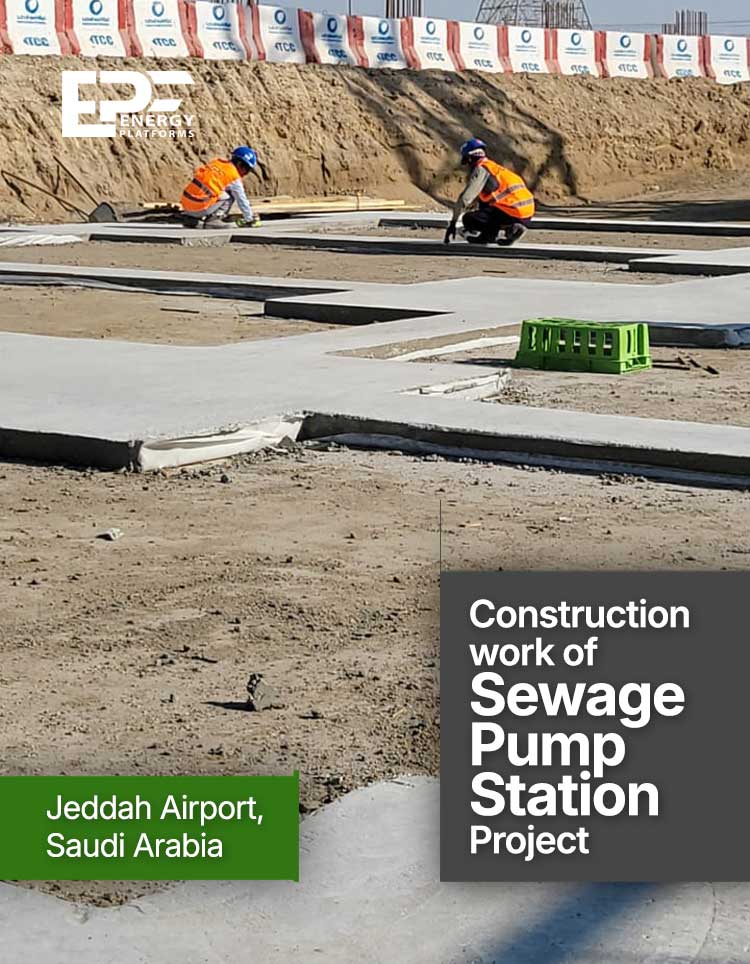

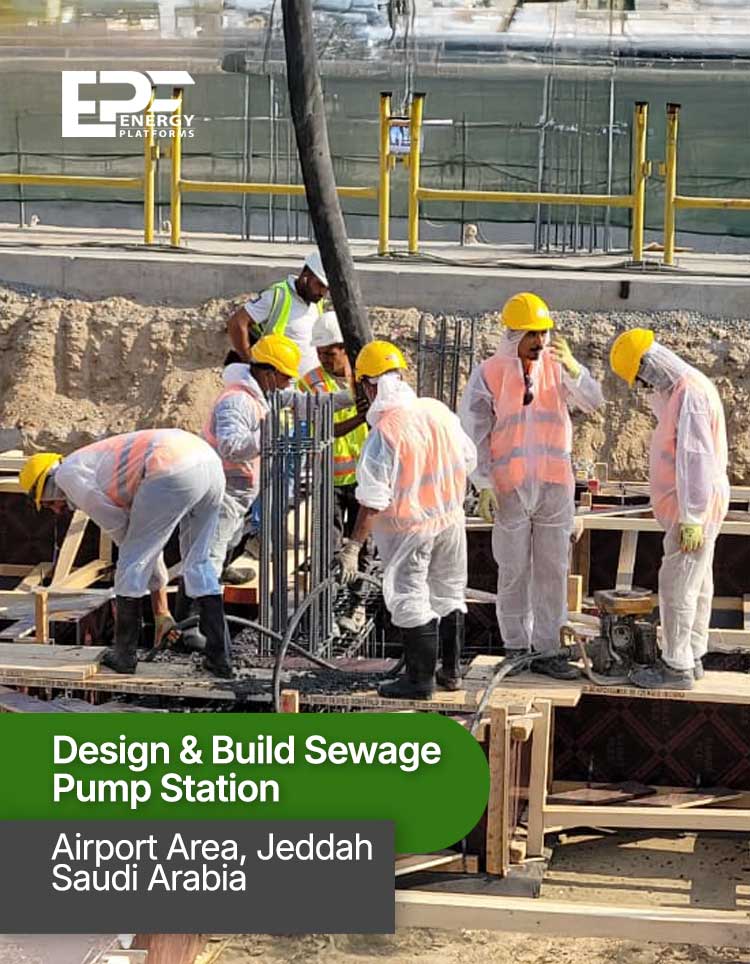

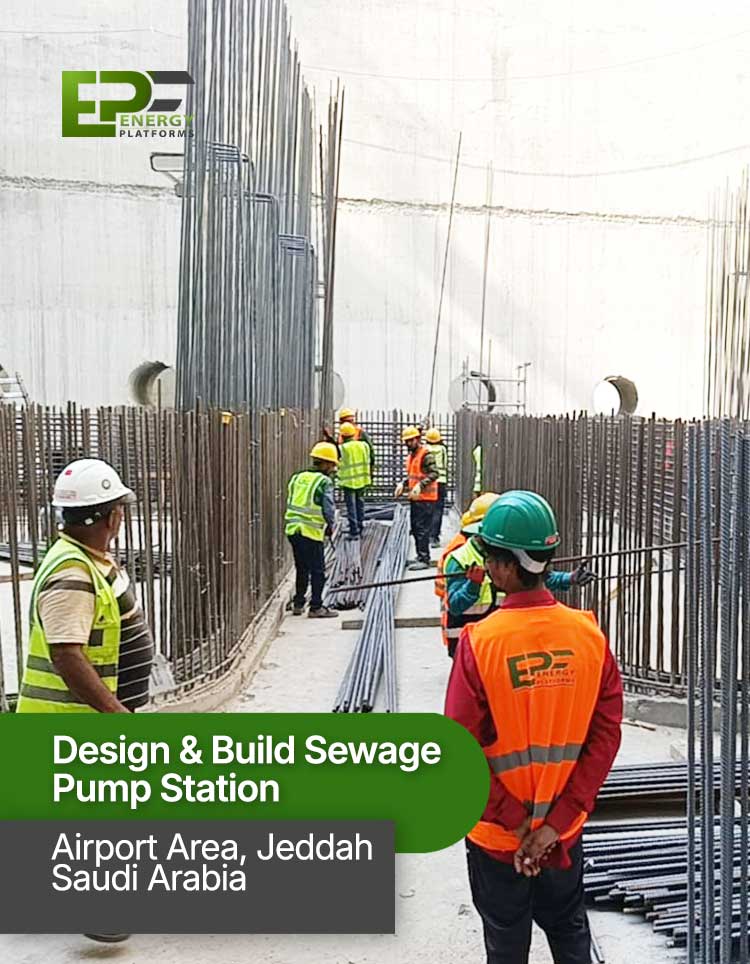

Footing Concrete Works

Footing concrete placed and finished under consultant monitoring. Curing and QA checks completed.

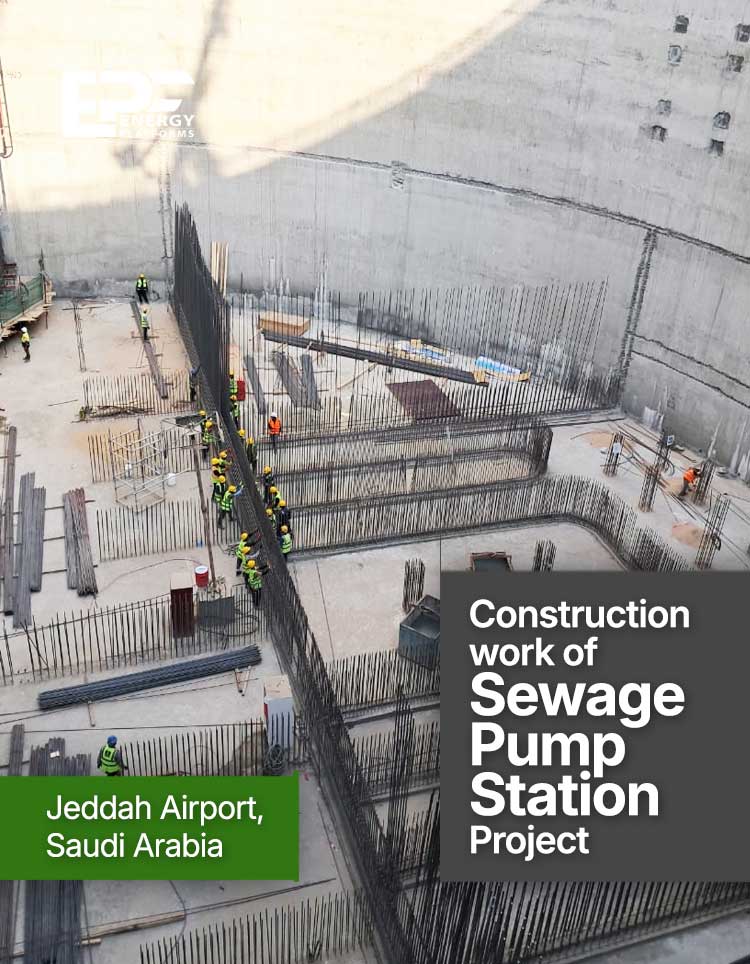

Phase 4

Reinforcement Installation of Main Shaft Building

Reinforcement cages assembled and tied within foundation areas. Grid alignment checked before advancement.

Phase 3

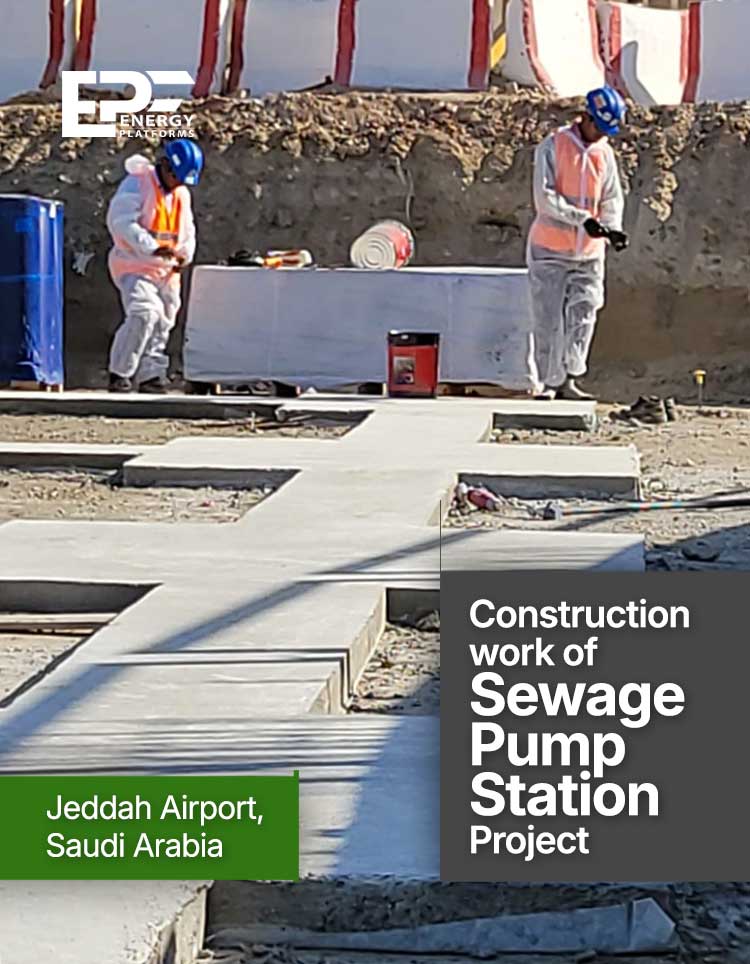

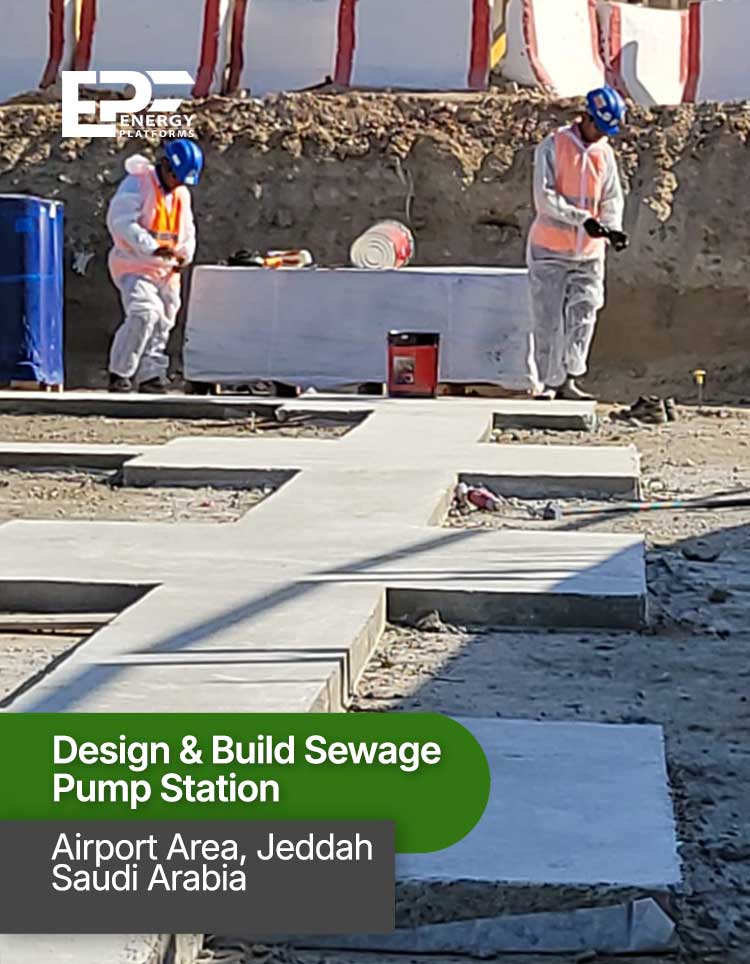

Waterproofing

Surface preparation and waterproofing of collection chamber blinding concrete.

Phase 2

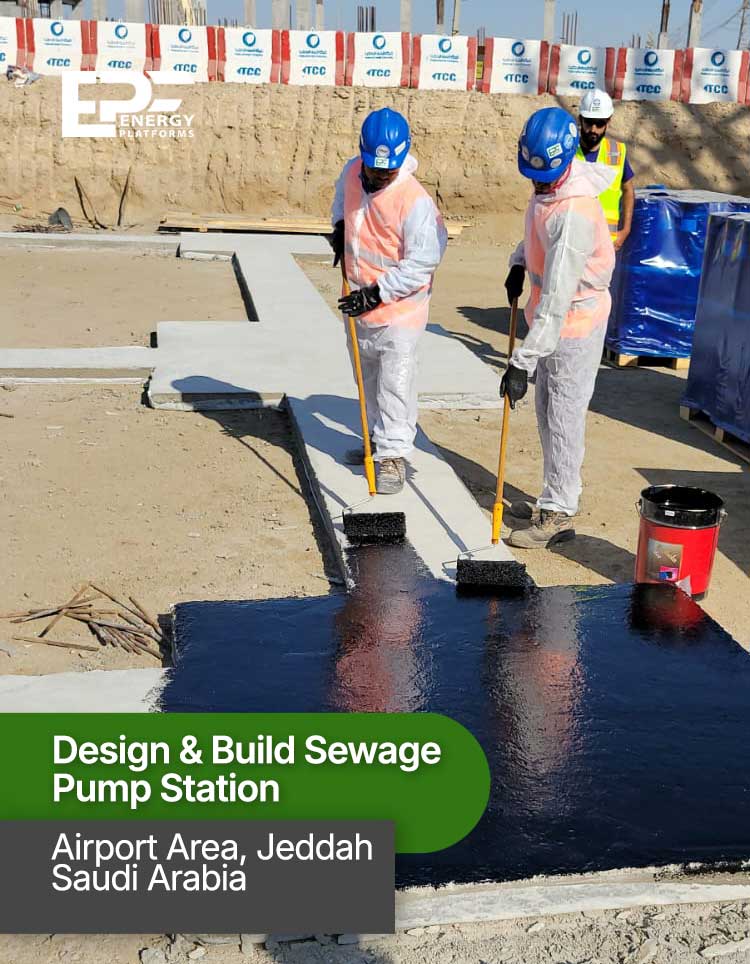

Formwork & Rebar Layout

Timber formwork set for footing zones. Rebar layout prepared and verified.

Phase 1

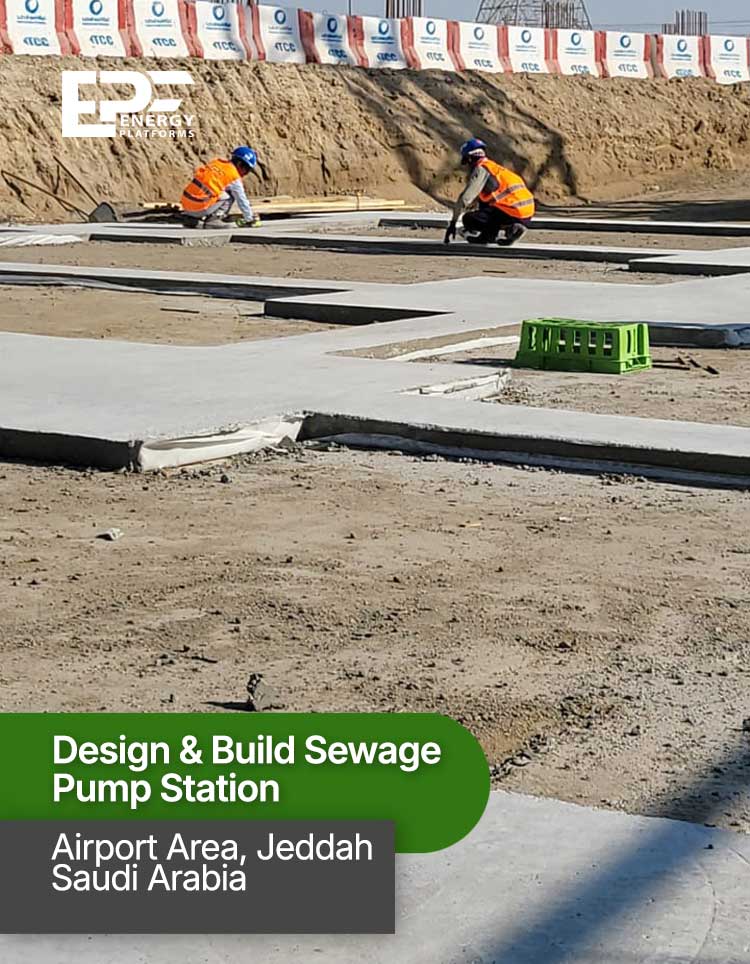

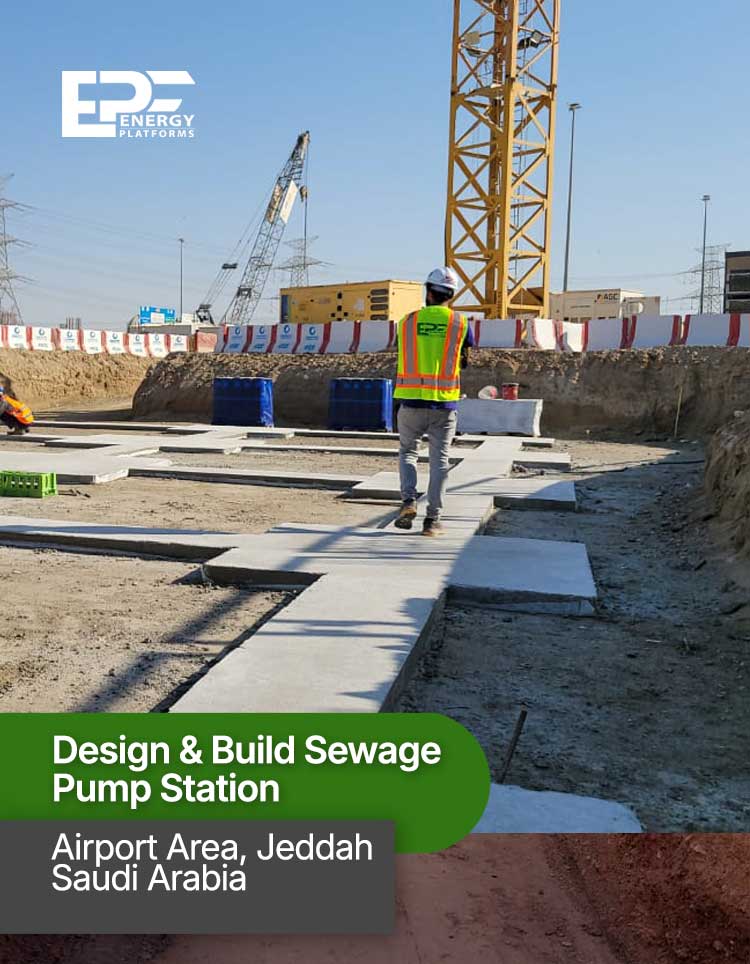

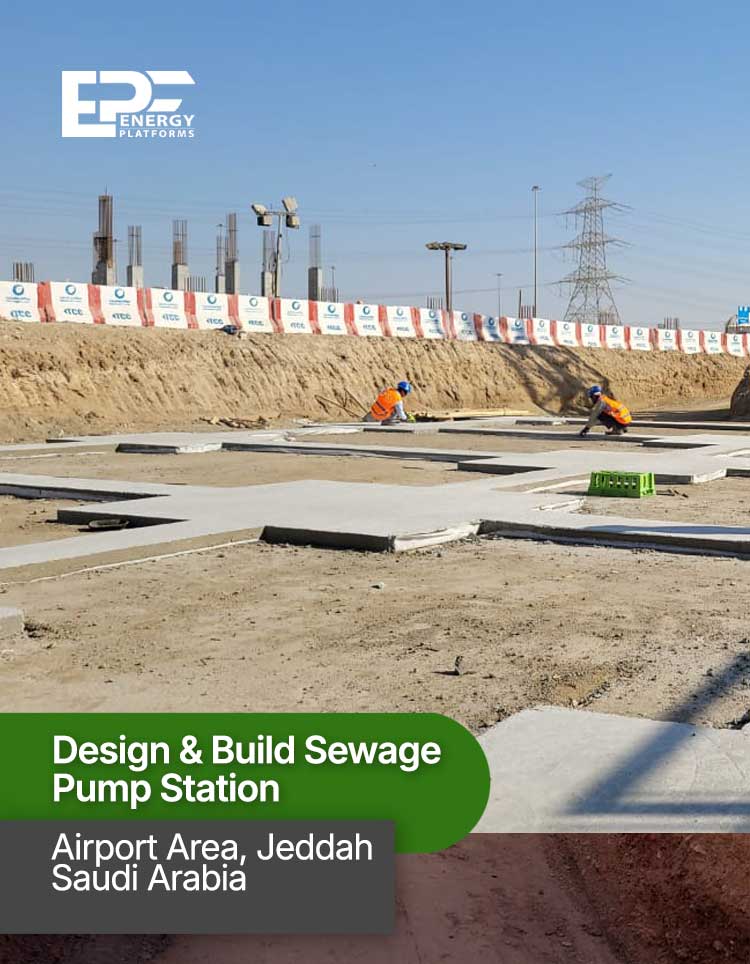

Site Preparation

Site clearing, leveling, and excavation completed. Foundation layout verified by consultant.
